Choosing the right foundation type is one decision. Actually building it is another. Once you've selected your foundation approach β covered in detail in our foundation comparison guide β here's what the construction sequence actually looks like for the most common types.
Concrete Slab Construction
A concrete slab foundation involves several sequential steps that each need to happen correctly before the next begins:
- Excavation and sub-base preparation. The topsoil is removed and the sub-base is excavated to the required depth. A compacted gravel base (typically 4β6 inches) is installed and leveled. This is the most critical step: a poorly compacted sub-base leads to slab cracking and settling over time.
- Vapor barrier installation. A plastic sheeting vapor barrier goes over the gravel to prevent moisture from migrating up through the slab. In most climates, this is a code requirement.
- Reinforcement layout. Steel rebar or wire mesh reinforcement is placed in a grid pattern within the future slab thickness to give the concrete tensile strength. Your plan's structural details specify the required reinforcement schedule.
- Utility rough-ins. Any plumbing drains, electrical conduit, or other utilities that need to pass through the slab are installed and positioned before the pour. This is your last opportunity to do this without jackhammering through finished concrete.
- Forming and pouring. Perimeter forms are set to the correct height and level. Concrete is poured, screeded flat, and finished. The quality of the pour and finish directly affects what gets built on top of it.
- Curing. Concrete needs time to cure properly β typically at least 28 days to reach full design strength, though construction can begin sooner in most cases. Rushing this step leads to weaker concrete.
Concrete Pier (Post) Foundation Construction
Pier foundations are generally faster and less expensive than slabs, and better suited to sloped or uneven sites.
- Layout and marking. Pier locations are staked out according to your foundation plan. Accuracy here matters β piers that are off-center or out of square create compounding problems in the framing above.
- Drilling or digging. Holes are drilled or dug to the required depth below the frost line. In colder climates, this can be several feet. Insufficient depth leads to frost heave β the piers literally move as the ground freezes and thaws.
- Forming and pouring individual footings. Concrete is poured into tube forms (Sonotubes are common) at each pier location. The top of each pier is set to the same elevation β getting all piers level with each other is critical for a level floor above.
- Post installation. Once piers have cured, posts or saddle hardware are set into the fresh concrete or anchored to the cured pier tops. Posts support the beam and floor framing above.
Basement and Walkout Basement Construction
Basement foundations are the most complex and most expensive option, involving significant excavation and more structural work than either slabs or piers.
- Excavation. Heavy equipment excavates to the required basement depth, which must go below the frost line and allow for adequate ceiling height in the basement level. On sloped sites, a walkout basement uses the natural grade to expose one or more walls at grade level.

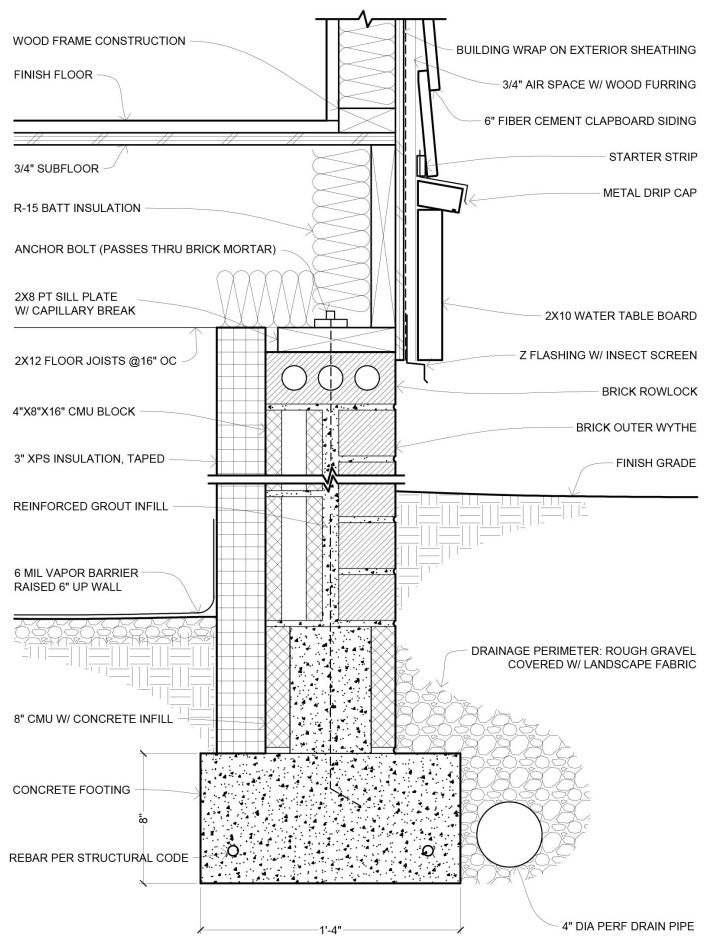

- Footings. Perimeter concrete footings are poured at the base of the excavation to support the foundation walls above.
- Foundation walls. Concrete block or poured concrete walls are built up from the footings to grade level. Waterproofing is applied to the exterior of the walls before backfilling.
- Drainage and waterproofing. A perimeter drain tile system is installed at the base of the foundation walls to channel groundwater away from the structure. This is not optional in most climates.
- Backfilling. Once walls are cured and waterproofed, excavated material is backfilled against the exterior walls. Backfilling too early (before walls have adequate strength) can cause wall failure.
Inspections During Foundation Work
Most jurisdictions require at least one inspection during foundation construction β typically before the pour for slabs, and after wall construction for basements. Your local building department will specify what they need to see and when. Don't skip these inspections; they protect you as much as they protect the code.
Bottom Line
Foundation work is not forgiving of shortcuts. The steps are sequential and each one creates the conditions for the next. Work with an experienced concrete contractor for this phase even if you plan to DIY the framing and finishing work above β foundation mistakes are among the most expensive to correct after the fact.
